Logic Pac · Production Timelines

The custom packaging timeline, phase by phase.

A realistic schedule for discovery, design, prototypes, testing, production, quality control, and freight.

15 min readUpdated September 2026Design + Production

How long does custom packaging take?

A 12-week custom packaging program is possible for a tightly defined project with fast approvals, proven materials, available capacity, and a freight plan that fits the deadline. More complex structures, new tooling, repeated sampling, testing, or ocean freight extend the schedule. The timeline is protected in the brief and approval process long before production begins.

What to know

  • The first two weeks determine whether later phases stay on schedule.
  • Structural decisions must be resolved before artwork and finish approvals lock.
  • Test the real product inside the prototype—not an empty package.
  • Separate production time from freight time when setting the launch date.

01.Most delays begin before the production order

Every packaging project has the same six phases. The brands that hit shelf on schedule don’t move faster — they make decisions earlier and respect the dependencies between stages.

Here’s the pattern we see across hundreds of projects: delays don’t come from production. They come from indecision in the first four weeks. One material change in week 7 can push your launch by a month. One unclear brand brief in week 1 can compound into three rounds of redesign before sampling. Our custom packaging timeline article covers the phase-by-phase cost of delays.

This guide breaks down what actually happens in each phase, what kills the timeline, and what you can do upstream to protect a 12-week launch window.

What’s Inside
  1. Phase-by-phase breakdown of what happens, what to expect, and what kills the timeline
  2. The seven decisions that compress a project — and the five that extend it
  3. A phase-gate checklist your team can use to validate readiness at each stage
  4. FAQs on rush options, parallel processing, and when 12 weeks isn’t realistic
Futuremood premium rigid boxes with gold foil and foam inserts — finished production quality

02.Weeks 1–2 · Discovery & Briefing

This is where everything gets defined. Materials, sustainability requirements, budget parameters, brand guidelines, distribution channels, performance specs, and the shelf context the package needs to compete in.

What it looks like: stakeholder meetings, brand questionnaires, technical spec documentation, target sample collection. Nothing physical happens. It’s all alignment.

What kills this phase: rushing it. Most brands try to compress weeks 1–2 because “we already know what we want.” Then they rebrief in week 5 when prototypes don’t match the original vision, and the project loses 3 weeks. Use our packaging brief template to lock these decisions upfront.

The single highest-leverage decision in a 12-week timeline is how much rigor you bring to the first 10 days.

03.Weeks 3–4 · Design & Concept Development

Your designer is sketching, rendering, and exploring multiple structural and graphic directions. Working through how the design behaves in 3D, photographs, and survives a crowded shelf. Multiple concepts get refined to two or three directions for stakeholder review.

What you’re deciding: structure, primary palette, typography, finish strategy, opening mechanism. Color separations and special finish die plans get locked.

Common pitfall: approving “design direction” without resolving the structural decisions. A beautiful flat render that hasn’t been tested against actual product fit will fail at the prototype stage.

04.Weeks 5–6 · Prototyping & Structural Engineering

The design isn’t just beautiful — it has to work. This phase produces structural prototypes, validates fold lines and closure mechanics, and tests material performance. Embossing or special finish die tooling is created. Color match drawdowns happen on actual substrates.

What you’ll see: first physical samples, often hand-built, sometimes 3D-printed. They’re rough. They’re not meant to be pretty — they’re meant to validate that the design is producible.

Don’t skip: putting your actual product into the prototype. Empty packaging always fits. Filled packaging is where you find the issues.

05.Weeks 7–8 · Sampling & Testing

First samples come off the production tooling. You’re evaluating color match, finish quality, structural durability, label registration, and how your actual product feels inside the packaging at production-grade quality.

Adjustments happen here. A second sample run might be needed. Drop tests, moisture testing, or compression testing happen on schedule. This is the last window to make changes before production tooling locks.

06.Weeks 9–10 · Production Setup & QC

Tooling is finalized. Your manufacturer prepares production runs. Artwork approvals lock. Material sourcing confirms. Trial runs test for consistency. QC parameters are documented.

This is the phase that prevents disasters at scale. Brands that skip a press check or trial run are the ones who discover color drift, registration issues, or finish defects in week 12 — when there’s no time to fix them.

07.Weeks 11–12 · Delivery & Final QC

Production runs at volume. Quality audits happen on output. Final product is inspected, packed, and shipped to your warehouse, fulfillment center, or retail DC. Delivery timelines vary by geography — domestic ground freight is 3–5 days; ocean freight from Asia is 4–6 weeks (plan that into your overall window).

08.What compresses the timeline — and what extends it

What compressesWhat extends
Pre-locked design direction — you already know your brand aestheticMid-project material change — adds 3–5 weeks per change
Existing material library — you’ve tested what works in your categoryStakeholder indecision — every revision round adds 5–7 days
Simplified structure — fewer custom finishes mean faster toolingCustom material specifications — extends sourcing 2–4 weeks
Domestic / regional production — shorter shipping timesInternational freight — adds 4–6 weeks ocean transit
Parallel-processing partner — design + tooling + sourcing in parallelSequential workflow — each phase waits for prior approval
Brief discipline — comprehensive Week-1 documentationRegulatory compliance changes — material sourcing pivots
Pre-vetted suppliers — no RFQ cycles neededSustainability requirement added mid-project — full restart

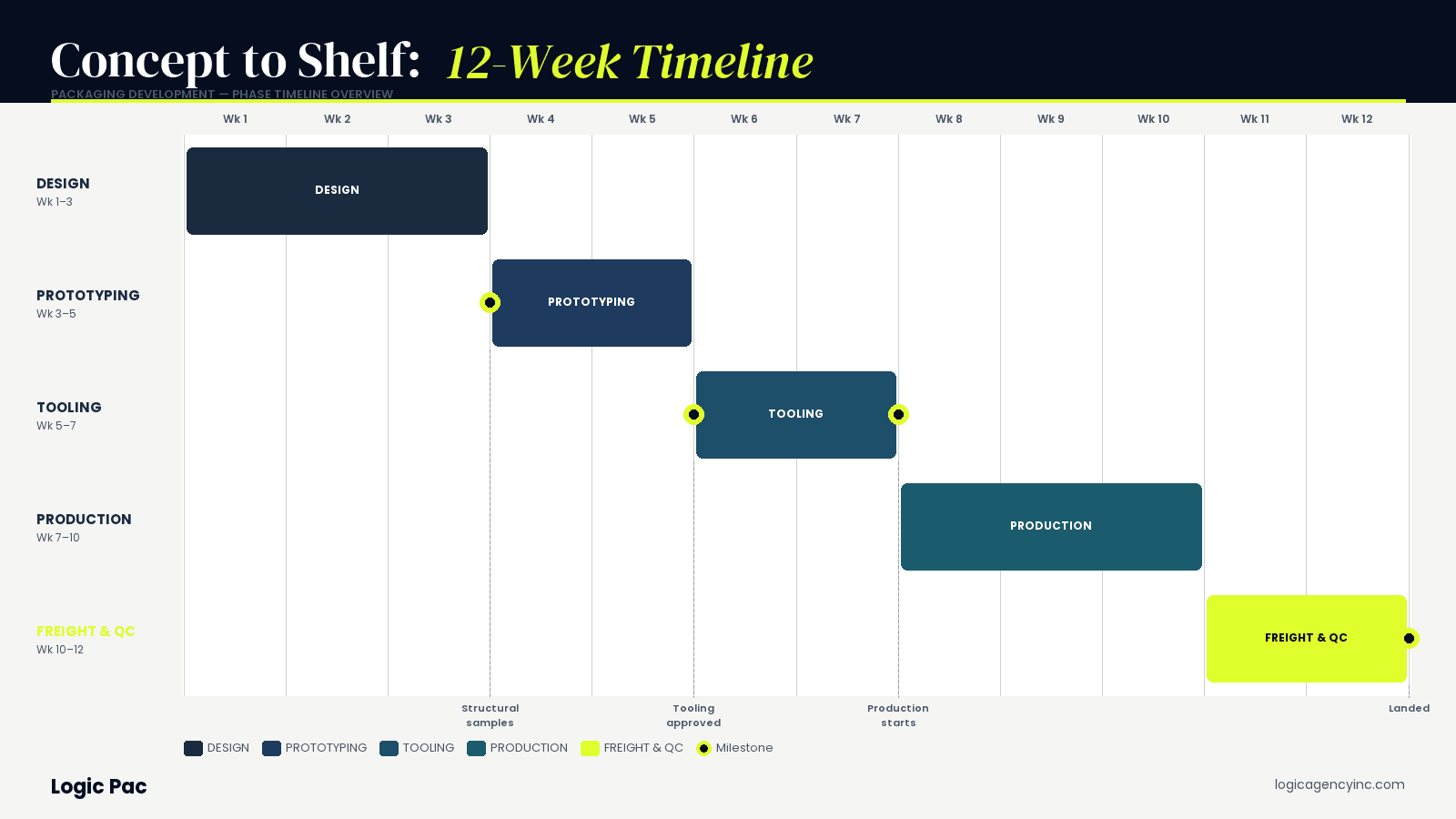

12-week concept-to-shelf packaging timeline — design, prototyping, tooling, production, and freight phases

09.The phase-gate checklist

Use this at the end of each phase. If you can’t answer yes to every item in a gate, don’t move forward — the cost of fixing it later is higher than the cost of waiting now.

Gate 1 (end of Week 2) — Brief lock

  • Materials, finishes, and structural format are documented
  • Sustainability requirements are explicit (PCR %, certifications, regulatory jurisdictions)
  • Distribution channels are confirmed (retail, DTC, both — each affects spec)
  • Budget per unit and per project is approved
  • Stakeholder approval chain is mapped

Gate 2 (end of Week 4) — Design lock

  • Final structural design selected and tested for product fit
  • Color palette specified by substrate (not just by Pantone)
  • Finish strategy committed (matte, soft-touch, foil — and where)
  • Print files prepared to spec

Gate 3 (end of Week 8) — Sample approval

  • Production-grade sample matches design intent
  • Color drawdowns approved across all substrates
  • Drop, compression, or moisture tests passed
  • Product fits, dispenses, and seals correctly

For a real-world example of this timeline executed across a growing SKU portfolio, see the Epicutis packaging program case study.

Bottom line

Speed comes from fewer late decisions, not less diligence. A clear brief, named approvers, defined testing, and an agreed freight plan do more to protect launch timing than asking production to move faster after the project has drifted.

Still Have Questions?

Most brands lose weeks because the brief was too thin to hold its shape under design pressure. We help you lock the brief, choose the right structural format, and route the work to suppliers who can deliver — without rebriefing in Week 5.

Quick Answers

Packaging Timeline FAQs

Sometimes. It requires pre-locked design direction, existing material specs, available capacity, and phases that can safely run in parallel. Rush costs and feasibility vary by supplier and format. Do not compress the briefing and approval decisions that protect later phases.
Glass often requires added structural engineering, protective packaging, and drop testing. The schedule impact depends on the format, channel, test protocol, and whether an e-commerce variant is required.
Add 4–6 weeks for ocean freight and 1–2 weeks for customs and warehouse intake. A “12-week” Asia-sourced project is realistically 16–18 weeks. Plan accordingly.
Approving design direction in Week 4 without a structural prototype. The package looks great in renders, fails physically in Week 6, and the project unwinds back to design.
Yes — we publish one. The faster and clearer the brief, the faster the project.

Hit the
